Reed contracting began construction in July 2019. The project is 60% complete and is anticipated to be completed by summer 2021.
Updated March 5, 2021
The design and right-of-way acquisition are approximately 95% complete for the project. There are a total of eighteen (18) structures to be removed with one structure remaining in acquisition. The City has removed 75% of structures to clear the site for roadway work to begin. Utility relocations are anticipated to begin in late 2021 with roadway construction anticipated 2022-2025.
Updated March 5, 2021
Concept drawings are under review, and design is approximately 30% complete. Determining right of way acquisition limits. Cost estimates for right of way acquisition and construction far exceed the $30 million the City of Huntsville and ALDOT budgeted for construction. The current cost estimate is near $60 million and the City and State are working to seek additional funding while the design continues to proceed. A new public involvement meeting is scheduled for fall 2021. Right of of way acquisition is expected to begin in 2022 with construction anticipated in phases from 2025-2029.
Updated March 5, 2021
ALDOT has completed right-of-way acquisition for the project. Design is 70% complete. There are eleven (11) structures to be demolished and removed prior to beginning utility relocations on site. ALDOT is currently performing removal of all structures in conflict with the roadway project and is 90% complete. Multiple utility conflicts exist on site. Utility relocations are scheduled to begin early 2021 with sanitary sewer being the first to get relocated. Roadway construction is anticipated 2022-2026 or upon completion of utility relocation.
Updated March 5, 2021

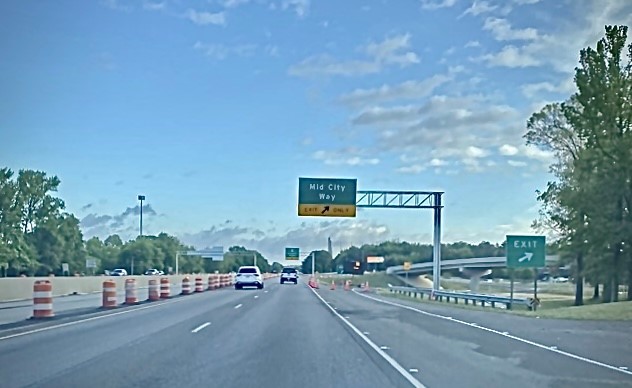

Construction began January 2020. The contractor has resurfaced the outer lanes to shift traffic while continuing to work in the median of Research Park Boulevard. Two lanes in each direction ( four lanes) on SR 255 will remain open daily between 6 a.m. to 8 p.m. with the additional lane construction on SR 255 anticipated to last 12-months, or 365 working days (weather permitting). The contractor is 75% complete with the roadwork along SR 255 and is paving two lanes in the center. Crews are installing a new concrete barrier wall in the center median as site conditions allow. The median is at the low point of the project limits collecting stormwater runoff, which results in saturated soil conditions throughout the winter months. The Bradford Drive northbound ramp bridge is complete and the contractor is currently installing a new exit ramp at MidCity.
The Old Madison Pike bridge will consist of new wider travel lanes, 10-foot wide multiuse paths on each side, and decorative rails and lighting. The contractor continues to stage construct the Old Madison Pike bridge, which is approximately 45% complete while traffic continues to have one lane in each direction while under construction. The north half has been demolished and new girders have been set over the roadway. The abutment was redesigned due to shallow rock encountered. The north half of the new bridge is scheduled to be assembled in Spring 2021. Two lanes will then be shifted to the new bridge (north side) to begin demolition and reconstruction of the south half.
All work on this project is anticipated to be completed by late 2021 due to the staggered construction timelines associated with the bridge schedule.
Updated February 23, 2021
The Huntsville Area Metropolitan Planning Organization is the transportation planning agency for Huntsville, Madison County, and the cities and towns of Madison, Owens Cross Roads and Triana.
